Healdsburg Vineyard Hotel by Appellation Hotels

Luxury Hotel in California’s Wine Country High-Unemployment TEA Senior EB-5 Loan Project approved by USCIS

Introducing Healdsburg Vineyard Hotel, an exquisitely planned luxury hotel development poised to elevate the hospitality experience in California’s wine country. Set on 8 acres in the picturesque town of Healdsburg, this fully-entitled project featured 108 luxurious keys, including 99 rooms and 9 suites, designed to offer the ultimate in comfort and style. Guests delighted in exclusive amenities such as a 100-seat signature restaurant, a chic 60-seat rooftop bar, and over 15,500 square feet of state-of-the-art event space, alongside a modern fitness club, a tranquil spa, and multiple swimming pools.

Healdsburg is celebrated not only for its scenic beauty but also as a culinary and wine epicenter, frequently listed by Fodor’s Travel as “one of the best small towns in America.” Nestled at the intersection of Alexander Valley, Chalk Hill, Dry Creek Valley, and Russian River Valley, the town offers an unmatched backdrop for this new development. With its vibrant food scene featuring Michelin Star dining and charming family-owned bakeries, Healdsburg provides a unique blend of local flavor and sophisticated taste. Healdsburg Vineyard Hotel represented a premier investment opportunity for EB-5 investors looking to capitalize on a project that promises to attract visitors from around the globe and generate significant economic impact.

Development Components

Vertical construction started in 2023

  • 8.12 acres of fully-entitled, wholly owned land
  • 4.5-star 108-key luxury hotel
  • 11k+ square feet of building area including covered outdoor space
  • Hotel area includes 14 buildings (up to 3-story structures)
  • 9 suites ranging from 660-1,460 square feet
  • 99 rooms ranging from 300-350 square feet

The EB-5 Program Highlights

Minimum Investment Amount:

$800,000

10% Visa Set-Aside as High Unemployment TEA

World Famous Resort Developer with Strong Track Record

EB-5 Senior Secured Loan

Projected Job Creation of 1,025+ with a Job Cushion of 95%

3-Year Senior Loan Term with Two 1-Year Extensions (3+1+1)

I-526E Denial Repayment and Completion Guarantees

Regional Center Success

17th EB-5 fund offered by GGG with 100% USCIS approval rate*

EB-5 Financing Available

Project Advantages

High-Unemployment TEA EB-5 Project

The Appellation Healdsburg Hotel is in a high-unemployment area and qualifies for the annual 10% set-aside for rural projects per the EB–5 Reform and Integrity Act of 2022 (RIA).

I-526E Denial Repayment

Loan repayment guarantee by the development team in the event of an I-526E petition denial.

Short Loan Term

3-Year Loan Term with Two 1-Year Extensions (3+1+1)

Completion Guarantee

A project completion guarantee that covers all expenses and cost overruns involved with completing the development.

Regional Center Success

This is the 17th EB-5 fund offered by Golden Gate Global and follows a perfect track record of project approvals.

Project is Under Construction

The Appellation Healdsburg Hotel completed construction and opened to guests in September 2025.

  • The hotel and restaurant are open
  • All building exteriors are complete (siding, masonry veneer, roofing, windows, lighting, etc.)
  • Exterior site landscaping is complete
  • Mechanical, electrical, plumbing, painting, and drywall construction activities are complete
  • The interior finishes are installed in all the hotel rooms and dining areas
  • The spa and pool areas are open
  • Furnishings are in place
  • Site Walls/Foundation: The site mass grading is complete.  The small retaining wall at the east of the clubhouse building was installed. The site walls were 95%+ completed this period with the masonry block walls generally installed at the front entry and the steel/wood interior screens in place.
  • Site Electric: The site electric was generally installed.  The conduit was installed.  The transformers and switchgear was set.  The electrical main components in the building were installed through the switchgear and transformers. Gas services were set but were waiting for connections
  • Wet Utilities: The site water, sewer, and storm drain main lines were installed. The grease interceptor was installed.
  • The concrete flat work was approximately 95% poured throughout the site. The pavers were installed at the rear of the clubhouse and west of the community center.  The entry drive circle pavers were in progress to 90%.
  • Pools:  The pools are complete through the pool coping, tile and gunite. The pool decks were poured.
  • Landscaping: The trees are complete throughout the site.  The irrigation is complete.  The drains are installed.  The planting around the building was 90% complete at the west and east village, 25% at the front buildings.

Construction Update by Buildings:

Clubhouse

  • The exterior is complete through the roofing and windows.  The exterior is complete through the siding and masonry veneer. The entry canopy structure was installed, the ceiling was framed and veneer was in place at the columns.
  • The interior is complete through the mechanical rough.  The plumbing top out is complete.  The HVAC ducting is complete.  The electrical rough is complete.  Fire sprinkler rough is complete.  The ceiling framing was completed at the first floor, ceiling materials were stored on site.
  • Drywall is complete.  Painting of the drywall was complete but touch up..
  • The HVAC hood equipment was installed at the kitchen and the hood surround was set.  Kitchen floor tile was complete.  The elevator was complete.  The stairs and rails are complete.  At the second floor, the units are complete through the cabinets and tops as well as tile at the bathrooms.  The bar is complete through the setting of the cabinet bases, the trim was in progress.

North Village 1

  • This period the exterior of the buildings are complete through the roofing and windows.  The siding was in place.  The upper deck waterproofing was installed.  Stairways were installed to the second floor.
  • The exterior walkways were installed.  The exterior rails and privacy panels were complete.
  • The interior of the hotel rooms was complete through the painting of drywall and trim.  Interior cabinets, tops, shower doors were in place.  The plumbing, HVAC, Fire Sprinkler and electrical trim were generally in place.  Flooring was in place and furnishings were in progress.

North Village 2

  • This period the exterior of the buildings are complete through the roofing and windows.  The siding was in place.  The upper deck waterproofing was installed.  Stairways were installed to the second floor.
  • The exterior walkways were installed.  The exterior rails and privacy panels were complete.
  • The interior of the hotel rooms was complete through the painting of drywall and trim.  Interior cabinets, tops, shower doors were in place.  The plumbing, HVAC, Fire Sprinkler and electrical trim were generally in place.  Flooring was in place.

Event Center

  • The event center is complete through the roofing, siding and windows.  The sliding doors were in place. The columns have masonry wrap in place. The soffit wood finishes were installed.  The service kitchen is complete through the equipment and drywall.  The commercial kitchen is complete but pickup.  The event area kitchen was generally installed.

Spa Building

  • The exterior is complete through the painting of siding and trim, roofing, windows, doors and downspouts.  The patio was complete.  Screen walls are complete.  The interior is complete through 90% of the painting.  Flooring was generally installed.  The tile was essentially complete.
  • The site walls are nearly complete with most masonry block walls installed and the steel/wood interior screens are in place.
  • The concrete flat work is poured throughout a majority of the property.
  • Walkways to the building are installed.
  • Pavers are installed throughout the property.
  • Landscaping work is underway.
  • The pool decks are poured.
  • The exterior roofing and window work are complete.
  • The siding and masonry veneer work are complete.
  • Many interior contractor trades are complete such as mechanical rough in, plumbing, HVAC ducting, electrical rough in, fire sprinkler rough in, ceiling framing at the first-floor level, most drywall installation throughout the buildings, and elevator as well as stair installation to name a few.
  • The project anticipates obtaining a TCO (Temporary Certificate of Occupancy) by Q4 2025.
  • The exteriors of all newly constructed buildings are being finished.
  • Hotel buildings have standing seam metal roofing installed, and building wrap and siding are in progress.
  • The interior mechanical rough-in is being finished.
  • The south paving of the property is done.
  • The site's electrical, water, sewer, and storm drain main lines are installed.
  • Windows are installed for the hotel buildings.
  • The pool gunite is poured.
  • Interior wall framing is complete and drywall is in progress.
  • Insulation is installed throughout the hotel buildings.
  • Stairways are installed.
  • Prime painting of the drywall is in progress.
  • Doors and windows are stored at the site and are being installed on 14 of the hotel building components spread across the property.
  • Large sheets of Tyrex are being wrapped around the outer structures of the buildings to prevent water moisture and wind damage to the framed hotel components.
  • HVAC and plumbing subcontractor work is ongoing.
  • Hardscape and stone paver installation work is starting.
  • Pool concrete pours are finished.
  • Exterior design & facade framing and stonework is ongoing.
  • Electrical and plumbing supplies are stored on site. Electrical work is ongoing throughout the development.
  • Painting and finish work will start in 2025.

News

USCIS Approves Appellation Healdsburg Hotel EB-5 Petition in Record Four Months

USCIS Approves Appellation Healdsburg Hotel EB-5 Petition in Record Four Months

Golden Gate Global (“GGG”), a leading U.S. EB-5 real-estate financing platform and owner of multiple regional centers, today announced that the Appellation Healdsburg Hotel has received an I-526E petition approval from U.S. Citizenship and Immigration Services (USCIS) in just four months, one of the fastest approvals on record for a high-unemployment Targeted Employment Area (TEA) project . Typical adjudication timelines range from 12 to 18 months .

News

Appellation Healdsburg Hotel is Officially Open

Appellation Healdsburg Hotel is Officially Open

The Appellation Healdsburg Hotel , an EB-5 project sponsored by Golden Gate Global , has now reached construction completion and is officially welcoming its first guests.

News

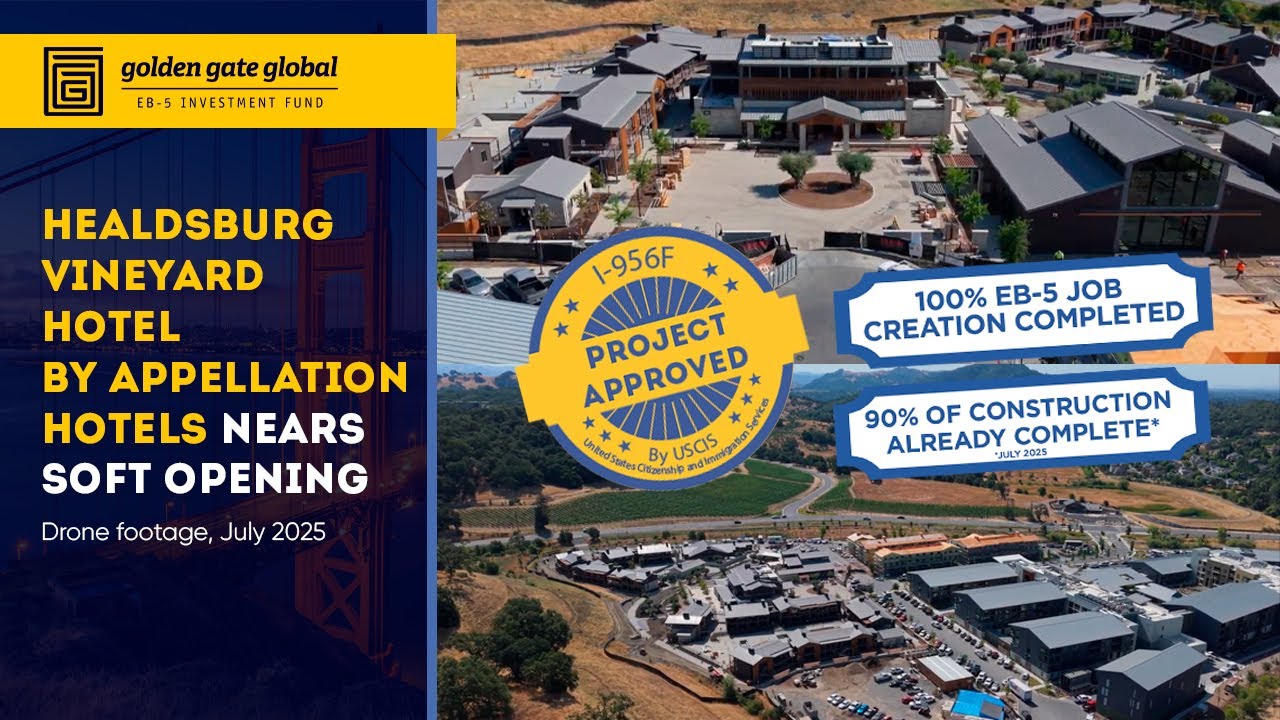

Healdsburg Vineyard Hotel by Appellation Hotels Nears Soft Opening

The Healdsburg Vineyard Hotel by Appellation Hotels , co-founded by renowned Michelin-star chef Charlie Palmer, is an EB-5 Project sponsored by Golden Gate Global that is on track to welcome its first guests in the third quarter of 2025. This luxury wine country resort showcases the significant impact of an EB-5 visa investment , driving job creation and local economic growth while enabling families from around the world to achieve U.S. permanent residency through the EB-5 program .

News

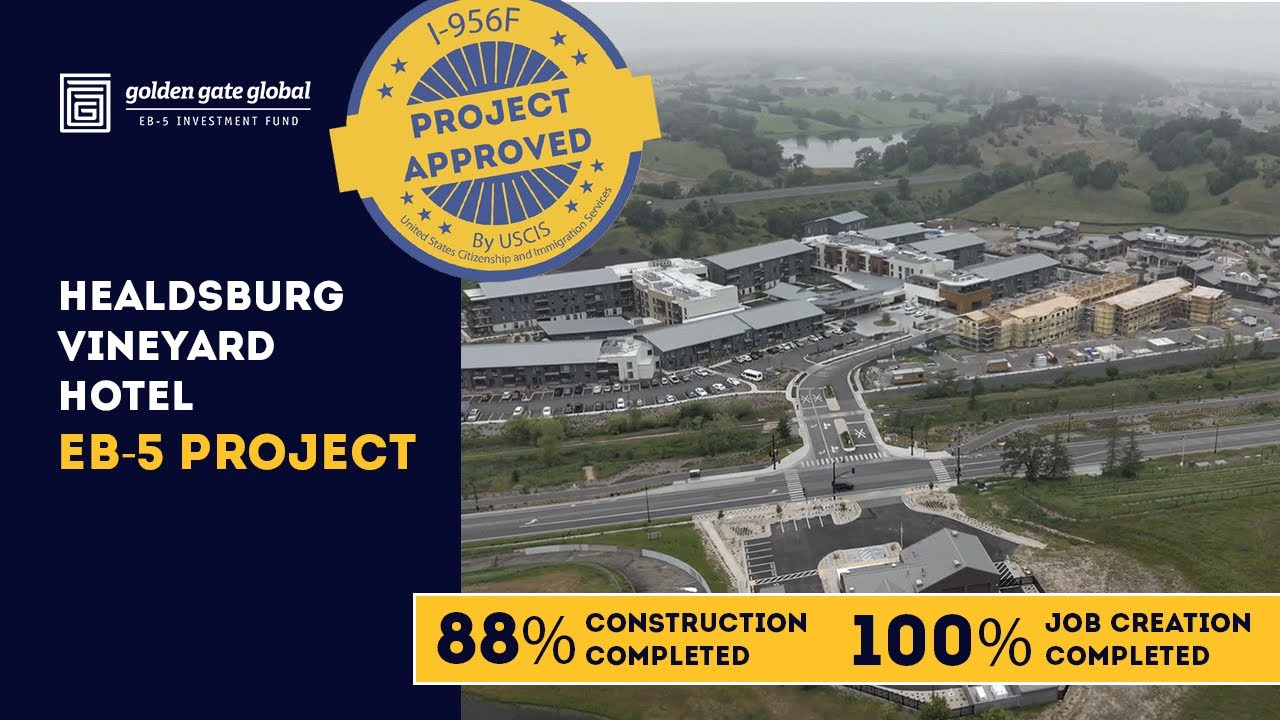

EB-5 Project Reaches 88% Completion: Healdsburg Vineyard Hotel by Appellation Hotels

The Healdsburg Vineyard Hotel by Appellation Hotels, an EB-5 investment project by Golden Gate Global , has reached a significant milestone, with 88% of construction now completed. Alongside this progress, the project has also achieved a major regulatory success. The U.S. Citizenship and Immigration Services (USCIS) has officially approved the project’s I-956F exemplar application . This confirms its status as a fully compliant EB-5 offering.

News

USCIS Approves Golden Gate Global’s EB-5 Project: Healdsburg Vineyard Hotel

USCIS Approves Golden Gate Global’s EB-5 Project: Healdsburg Vineyard Hotel by Appellation Hotels

Golden Gate Global (GGG), a leading California EB-5 investment firm and owner of multiple regional centers, is pleased to announce that its Healdsburg Vineyard Hotel EB-5 project has received I-956F exemplar approval from the U.S. Citizenship and Immigration Services (USCIS). T

News

Invest with Confidence: Healdsburg Vineyard Hotel EB-5 Project Achieves 100% EB-5 Job Creation with 70% Construction Complete

The Healdsburg Vineyard Hotel EB-5 project has made remarkable progress, with construction advancing swiftly since vertical construction began in 2023. Completion anticipated by the end of 2025. As of January 2025, development spending has surpassed $100 million, resulting in the creation of 688+ jobs. This milestone fulfills the required job creation for all the project’s EB-5 investors.

News

Golden Gate Global Announces New EB-5 Project: Healdsburg Vineyard Hotel

Golden Gate Global Announces New EB-5 Project: Healdsburg Vineyard Hotel

Golden Gate Global, unveils its new EB-5 project, the Healdsburg Vineyard Hotel. The project is located in the heart of Northern California wine country in the town of Healdsburg, just 65 miles north of San Francisco. The Healdsburg Vineyard Hotel is the 17th EB-5 fund offered by Golden Gate Global, one of the largest EB-5 regional center operators in the San Francisco Bay Area.

News

Get Started

Begin Your Journey

Take the first step toward securing U.S. permanent residency. Our EB-5 professionals provide confidential, no-obligation consultations to help you understand the EB-5 program, evaluate your eligibility, and explore whether it is the right fit for your family’s immigration and investment goals.

Free Confidential Consultation
No Obligation
Owner of Multiple USCIS-Approved Regional Centers

By submitting, you agree to our Privacy Policy. Your information is kept strictly confidential.
